Current Project Information
2025 Projects
*It's important to know that all project start/end dates are approximate and weather dependent.
Lake Superior Water Intake - Phase I
- Work Location: Lake Superior Waterfront in Ashland, WI
- Estimated Start Date: May 1, 2025
- Estimated Project Duration/Contract End Date*: 6 months - complete November 1, 2025
- Engineering Consultant: Greeley & Hansen (Chicago, IL)
- Contractor: Roen Salvage Company (Sheboygan, WI)
- Description: Construction of a new 4,560-ft long, 24-inch water intake pipeline and submerged timber crib intake structure in Chequamegon Bay. Also includes a new pre-chlorination system for the new intake. The existing intake pipeline will be repurposed as a secondary and backup raw water supply.
- Additional Funding Sources:
- Wisconsin Department of Natural Resources - Safe Drinking Water Loan Program
- Army Corps of Engineers - Environmental Infrastructure Assistance
- City of Ashland Water Utility
- Time-lapse Videos of Intake Project Progress
Ellis Avenue / State Hwy 13 Reconstruction
- Work Location: Ellis Avenue (State Hwy 13) from US Hwy 2 to Old Airport Rd (City Limits)
- Estimated Start Date: April 1, 2025
- Estimated Project Duration/Contract End Date*: 6 months - complete November 1, 2025
- Engineering Consultant: Short, Elliot, Hendrickson (Rice Lake, WI)
- Contractor: A-1 Excavating (Bloomer, WI)
- Description: Two lanes of traffic will be removed to provide two-way left hand turn lane to improve safety and enhance traffic flow. A bike lane will be added in both directions. Replacement of curb ramps, trail crossing, & some sidewalks. Also replacing pavement, pavement base, curb & gutter, storm sewer system, and the water main (originally installed in 1888). There are roughly 20 private lead service laterals (also known as LSL's) being replaced to help eliminate the exposure of drinking water to lead plumbing.
- Additional Funding Sources:
- Wisconsin Department of Transportation (WisDOT) - State Highway System
- Wisconsin Department of Natural Resources - Lead Service Lines
- City of Ashland Wheel Tax, General Fund, & Special Assessments
- City of Ashland Water Utility
- Special assessments were approved by the City Council and residents have received notification of such charges.
- Questions or concerns on traffic control can be directed to Mitch Finnegan with the WisDOT at 715-492-0665.
Turner Road Lift Station Improvement
- Work Location: 120 Turner Road - City Owned Sewage Pumping Station
- Estimated Start Date: September 15th (Weather Permitting)
- Estimated Project Duration/Contract End Date*: October 1, 2025
- Contractor: Ritola Inc.
- Description: Upgrades to structure and pumps provided sewer collection services to Prentice Heights, Junction Road, Bayview Lane, and Victoria Lane.
- Additional Funding Sources:
- Wisconsin Department of Natural Resources - Clear Water Fund
- City of Ashland Water Utility
East End Community Park Warming House
- Work Location: East End Community Park
- Estimated Start Date: July 15, 2025
- Estimated Project Duration/Contract End Date*: Complete by Dec 1
- Engineering Consultant: City of Ashland Parks Division
- Contractor: City of Ashland Parks Division
- Description: Installation of replacement bathroom & warming house building.
- Additional Funding Sources:
- City of Ashland - Parks Fund
- Donations
2025/2026 Lead Service Line Replacements (MORE TO BE COMPLETED IN 2026)
- Work Location: Various locations throughout the City including Ellis Ave, Chapple Ave, Willis Ave, Prentice Ave, & 13th Ave E.
- Estimated Start Date: May 2025
- Estimated Project End Date*: First round of replacements scheduled for 2025 have been completed. The second round of replacements are scheduled to be completed by December 2026.
- Engineering Consultant: City of Ashland Engineering Division
- Contractor: Ritola, Inc (Mason, WI)
- Description: Replacement of public and private lead service laterals at 92 locations throughout the City to help eliminate the exposure of drinking water to lead plumbing. Residents included in this project have already been contacted, and should contact Utility Engineer Madison Krzciok with the City of Ashland Engineering Division of Public Works.
- Additional Funding Sources:
- Wisconsin Department of Natural Resources - Lead Service Lines
- City of Ashland Water Utility
COMPLETED: Sanborn Avenue - Waterfront Trail Pavement Replacement
- Work Location: Lake Superior Waterfront Trail at Sanborn Ave
- Estimated Start Date: Jul 1, 2025
- Estimated Project Duration/Contract End Date*: 1 month - complete August 1, 2025
- Engineering Consultant: Short, Elliot, Hendrickson (Rice Lake, WI)
- Contractor: Angelo Luppino (Iron Belt, WI)
- Description: Replacement of existing deteriorated asphalt trail.
- Additional Funding Sources:
- Wisconsin Department of Administration - Coastal Management Program
- City of Ashland - Waterfront Development Fund
COMPLETED: 2025 Chipseals
- Work Location:
- 21st Ave E from US Hwy 2 to 6th St E
- 22nd Ave E from US Hwy 2 to 6th St E
- Streets that connect between 21st and 22nd Ave E
- Main St E
- 3rd St E
- 4th St E
- 5th St E
- Project was completed as of July 2025
- Engineering Consultant: City of Ashland Engineering Division
- Contractor: Fahrner Asphalt (Plover, WI)
- Description: Application of chipseal surface to extend lifetime of road surface.
- Additional Funding Sources:
- City of Ashland - General Fund
- Work Location:
COMPLETED: 2025 Skim Overlay
- Work Location: City Heights Rd
- Project was completed as of July 2025.
- Engineering Consultant: City of Ashland Engineering Division
- Contractor: Northwoods Paving (Ashland, WI)
- Description: Application of thin asphalt surface to extend lifetime of road surface.
- Additional Funding Sources:
- City of Ashland - General Fund
COMPLETED: Redevelopment of Kreher Park and RV Campground
- Work Location: Kreher Park RV Campground
- Project was completed as of July 2025
- Engineering Consultant: Parkitecture & Planning (Madison, WI)
- Contractor: Huffcut Concrete (Chippewa Falls, WI), Dreamland Contracting (Cable, WI)
- Description: Installation of bathroom/bathhouse building. Construction of new campsites & site work.
- Additional Funding Sources:
- American Recovery and Reinvestment Act (ARPA)
- Wisconsin Department of Natural Resources - Knowles-Nelson Stewardship Fund
COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects
- Click here to view a presentation from the project's Public Information Meeting.pcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects 2025 ProjectsUpcoming Projects 2025 ProjectsUpcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects COMPLETED: Chapple Avenue ReconstructionUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects
- Work Location: Chapple Avenue from 6th St W to 11th St W
- Estimated Start Date: May 15, 2025
- Estimated Project Duration/Contract End Date*: 5 months - complete November 1, 2025
- Paving will be applied in two layers by Northwoods Paving. The second layer will be applied in June 2026. This allows for a longer, better lasting product due to factors such as settling.
- Engineering Consultant: Northern Wisconsin Based Engineers (Hayward, WI)
- Contractor: Jake's Excavating (Ironwood, MI)
- Description: Replacing pavement, base, subbase, curb & gutter, storm sewer system, and the water main. Replacement of curb ramps, & some sidewalks. There will also be an installation of underdrain system. Bike sharrows (shared lane markers) will also be added to Chapple Avenue. There are roughly 20 private lead service laterals (also known as LSL's) being replaced to help eliminate the exposure of drinking water to lead plumbing.

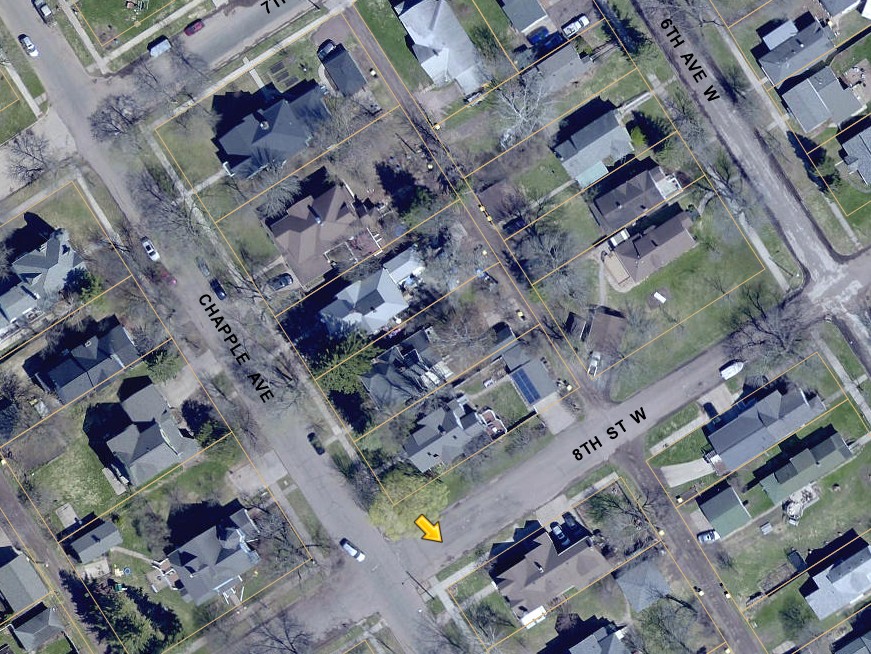

- Temporary Mailboxes are have been installed for residents. Click Here Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects 2025 ProjectsUpcoming Projects 2025 ProjectsUpcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects Upcoming Projects to see where they are located.
- Additional Funding Sources:
- Wisconsin Department of Transportation (WisDOT) - Local Road Improvement Program
- Wisconsin Department of Natural Resources - Lead Service Lines
- City of Ashland General Fund & Special Assessments
- City of Ashland Water Utility
- Special assessments were approved by the City Council and residents have received notification of such charges.
Upcoming Projects
2026 Projects
- Prentice Avenue Phase II Reconstruction (US Hwy 2 to 6th St E)
- Lower Willis Avenue Reconstruction (1 block; 11th St E to dead end)
- 13th Avenue E Reconstruction (Us Hwy 2 to 6th St E)
- Kreher Park Boat Launch Construction
- 2026 Lead Service Line Replacements
2027 Projects
- 3rd Street W Resurfacing (Sanborn Ave to Ellis Ave)
- Beaser Avenue Resurfacing (US Hwy 2 to Binsfield Ave)
- 11th Street E Reconstruction (Ellis Ave-Prentice Ave)
- Wastewater Treatment Plant Improvements Phase I
2028 Projects
- 11th Avenue E Resurfacing (US Hwy 2 to Pufall Drive)
- 11th Street W Resurfacing (Ellis Ave to Beaser Ave)
2029 Projects
- Wastewater Treatment Plant Improvements Phase II
